Capital Improvement Project

E2CCB Capital Improvement Project 2026

The 2026 Capital Improvement Project is a strategic plan to secure the future of the Erie 2-Chautauqua-Cattaraugus BOCES (E2CCB) infrastructure. This initiative is a foundational investment in the regional learning environments that serve students from across our 27 component districts. We’re working to ensure students enrolled in E2CCB programming remain WARM, SAFE, and DRY. This proposal is the result of a disciplined, transparent prioritization process. While a comprehensive Building Condition Survey (BCS) identified a total of $142 million in facilities needs, the current project has been meticulously narrowed to a $49.5 million “must-do” priority list. This targeted investment focuses on the highest-risk, highest-impact systems — such as roofs, boilers, and safety infrastructure — to prevent catastrophic system failures. We are moving forward with this disciplined scope to protect our regional assets and ensure educational continuity before the cost of emergency repairs or equipment failure escalates.
The project scope was determined through years of rigorous planning, including workshops and site-based evaluations. This collaborative approach allowed E2CCB to identify the requirements to maintain safe, reliable facilities while enhancing functionality to support current and future program needs.
The following table categorizes the $49.5 million investment across the E2CCB campuses:
System Type
Investment
Primary Work Included
Building Shell
$22.0 Million
Roof replacements at 12 buildings (out-of-warranty/deteriorated); exterior door upgrades.
Mechanical & Infrastructure
$12.0 Million

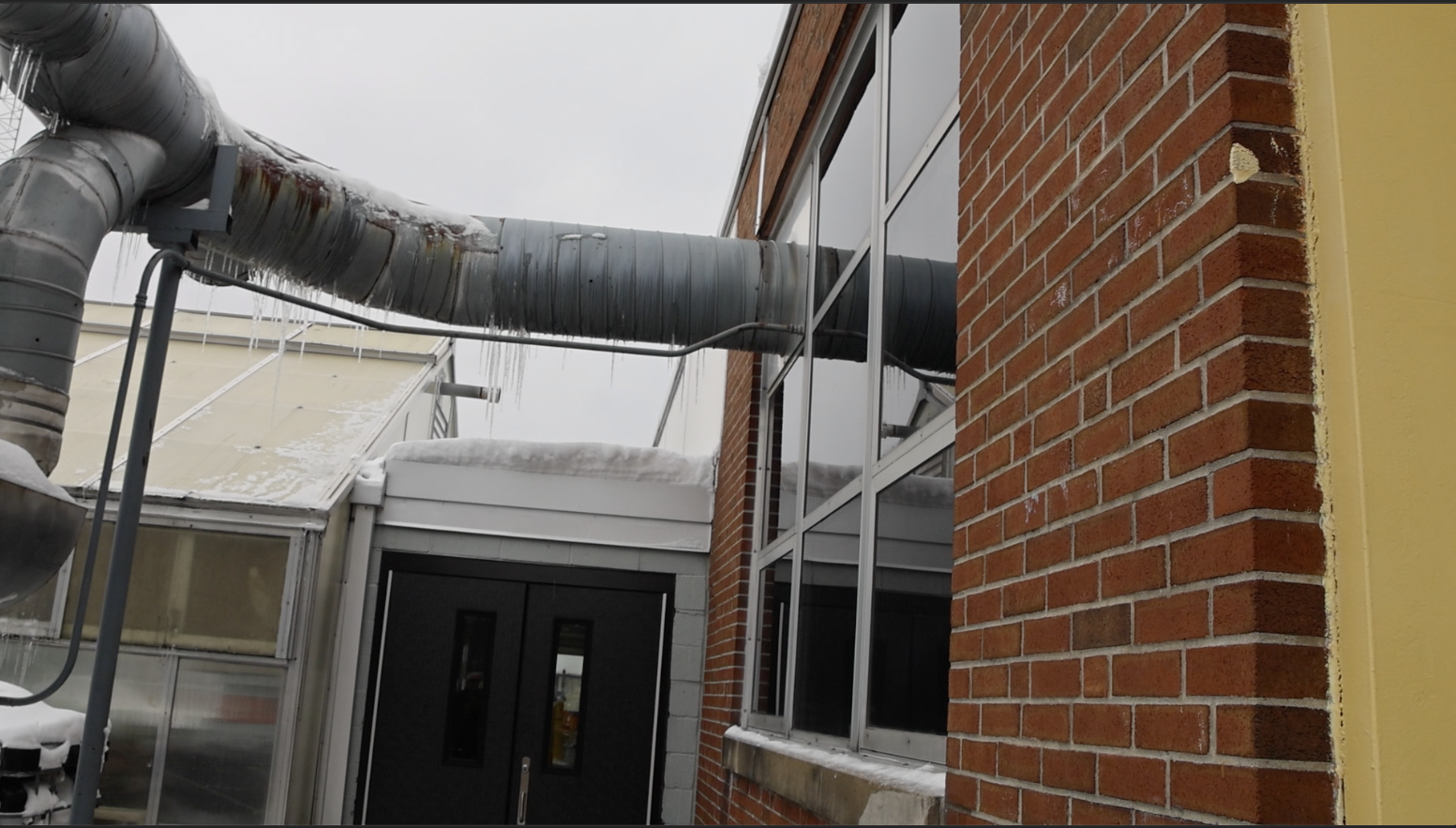

Replacement of outdated boilers and HVAC; mandated ventilation upgrades for air quality.
Safety, Site & Tech
$15.0 Million
Restoration of parking lots and sidewalks; replacement of Fire Alarms, PA, and Phone systems.
Plumbing
$0.5 Million
High-priority fixture replacements and critical supply line updates.
Beyond regional infrastructure, the project includes high-impact, campus-specific renovations designed to maintain operational integrity:

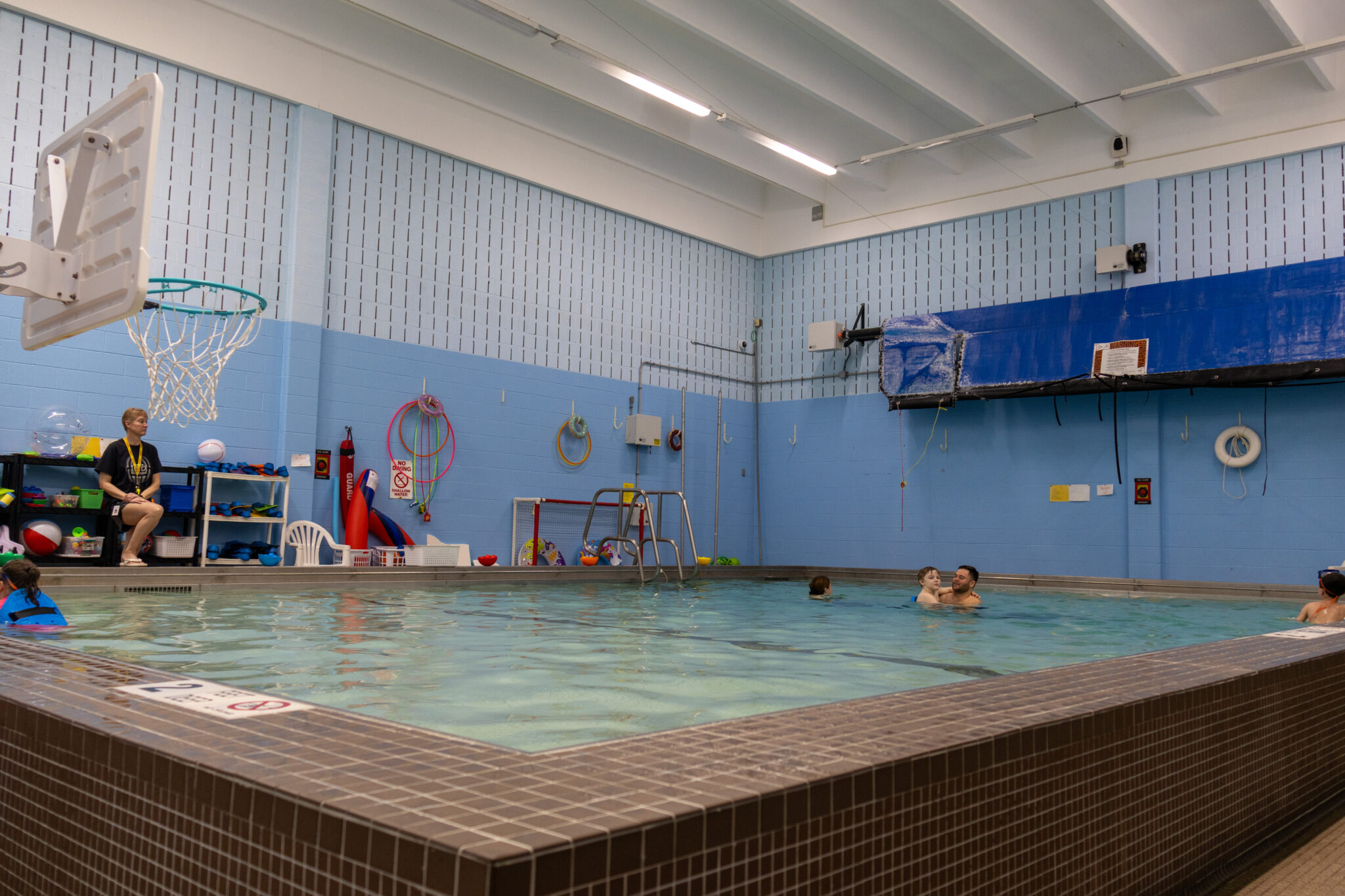

  • Hewes Educational Center: Installation of a secure entrance; comprehensive pool renovations including pool infill and therapy pool upgrades.

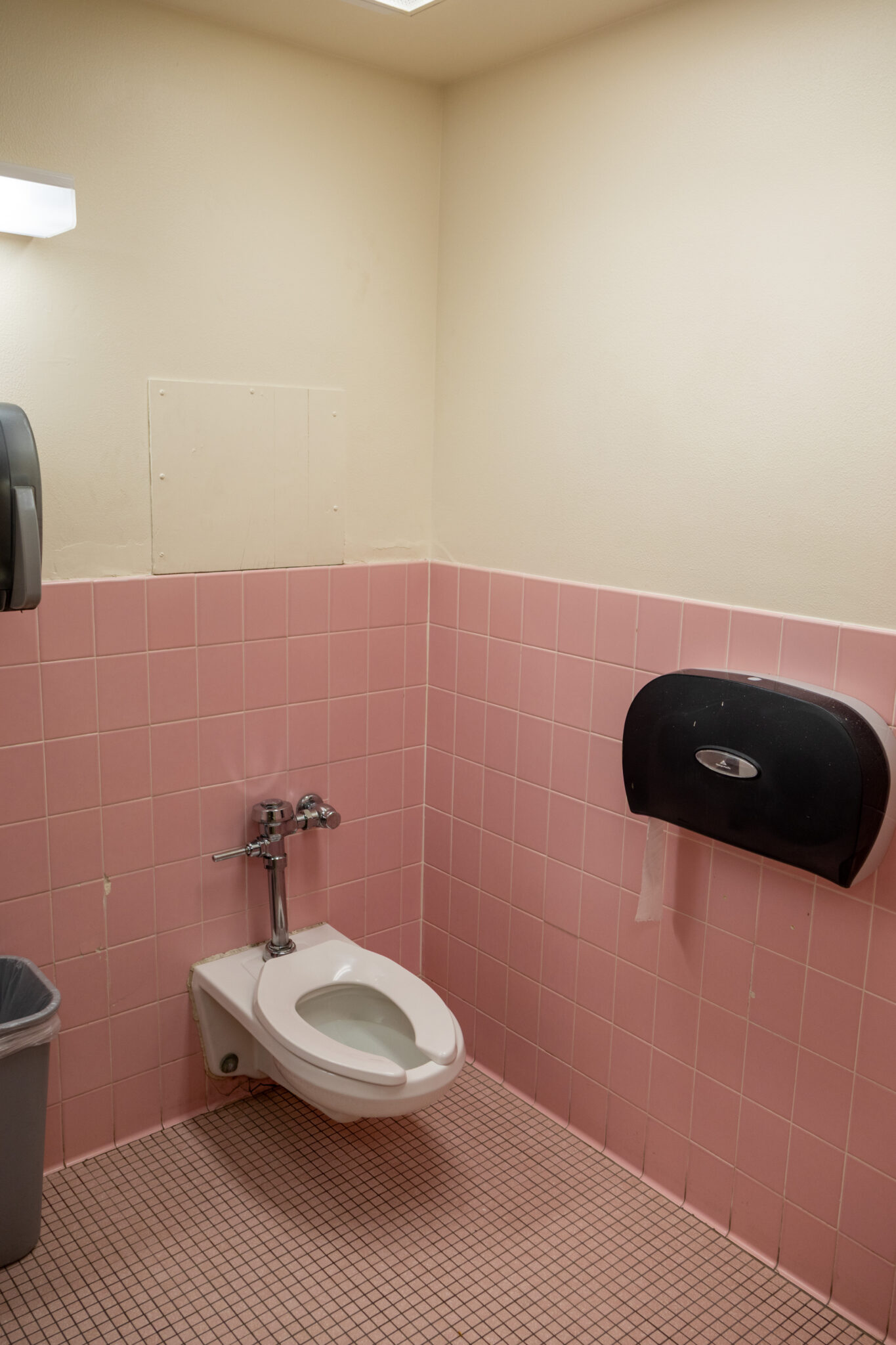

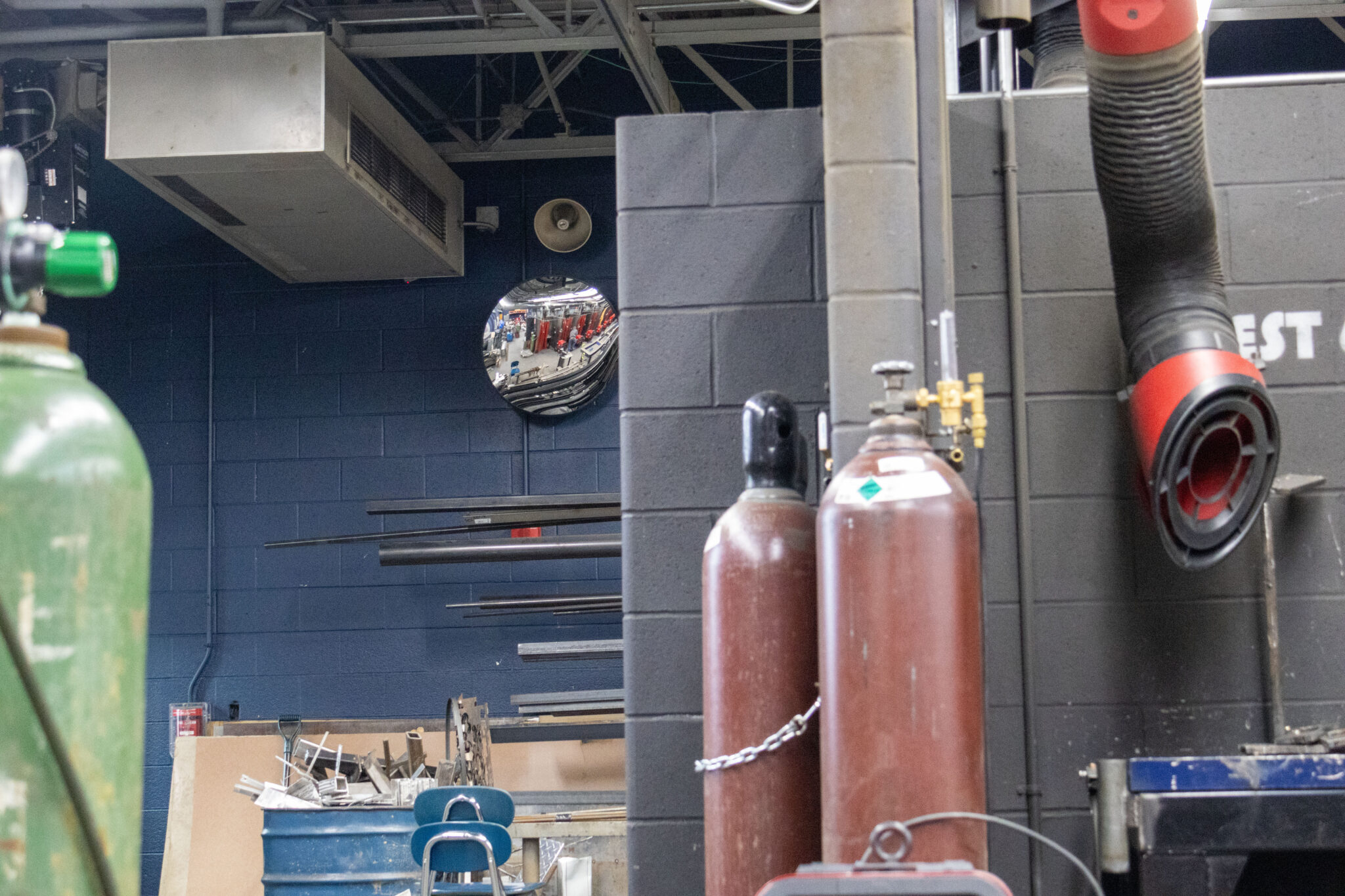

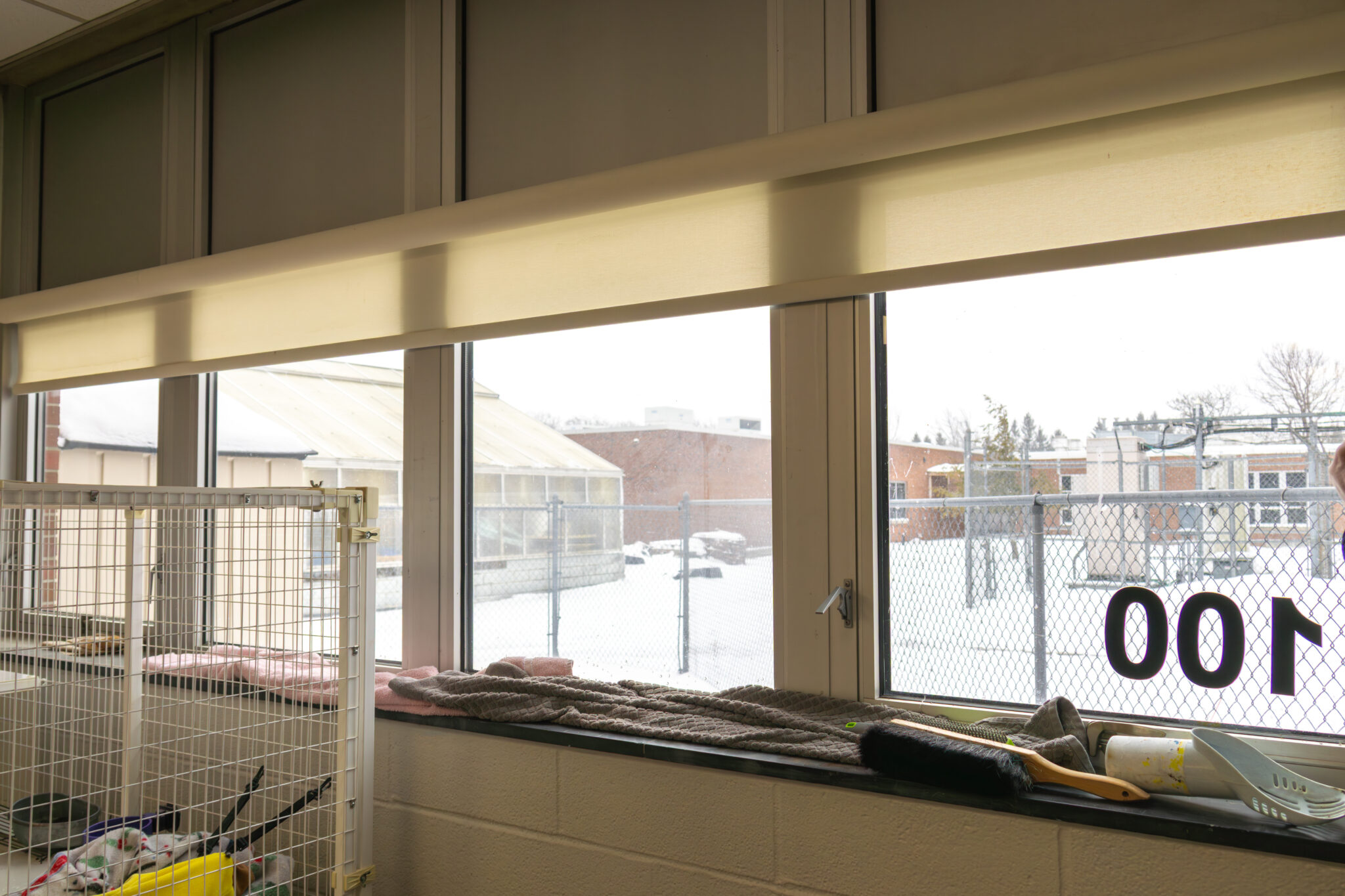

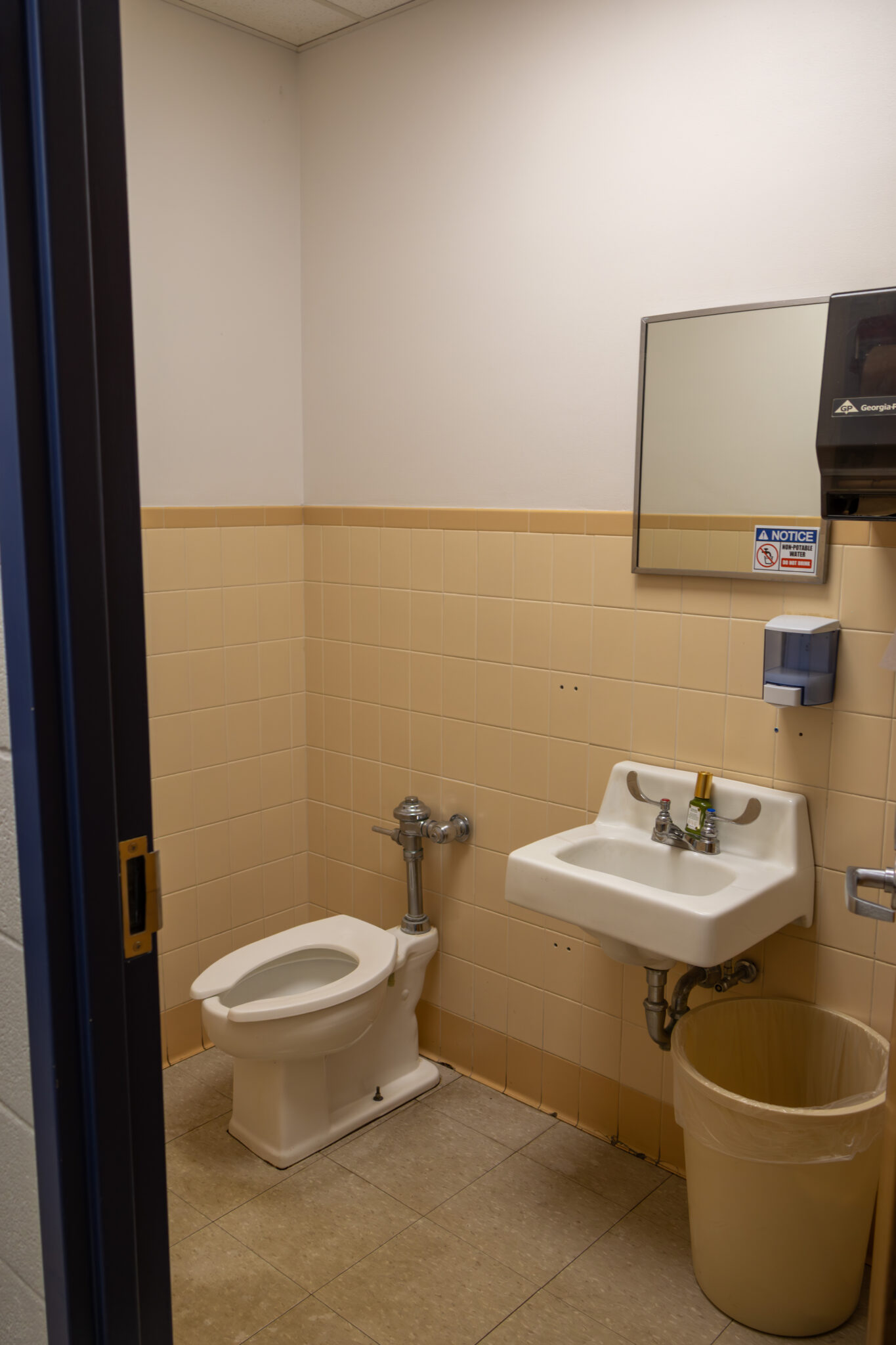

  • Ormsby Educational Center: Window and door replacements; building repointing; welding shop upgrades; toilet room and flooring renovations.

  • Carrier Educational Center: Small Animal Science program renovations; essential sewer line improvements.

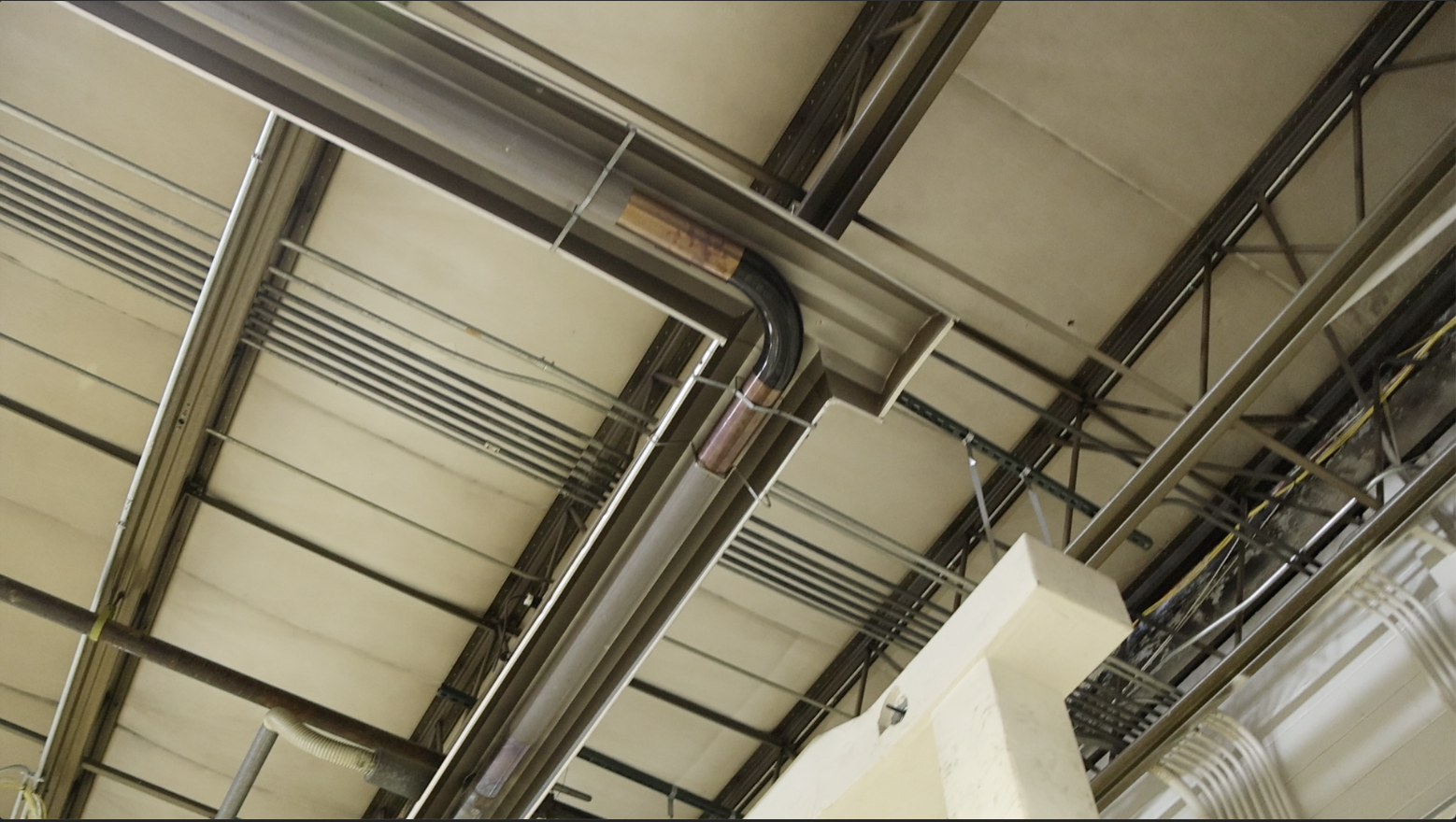

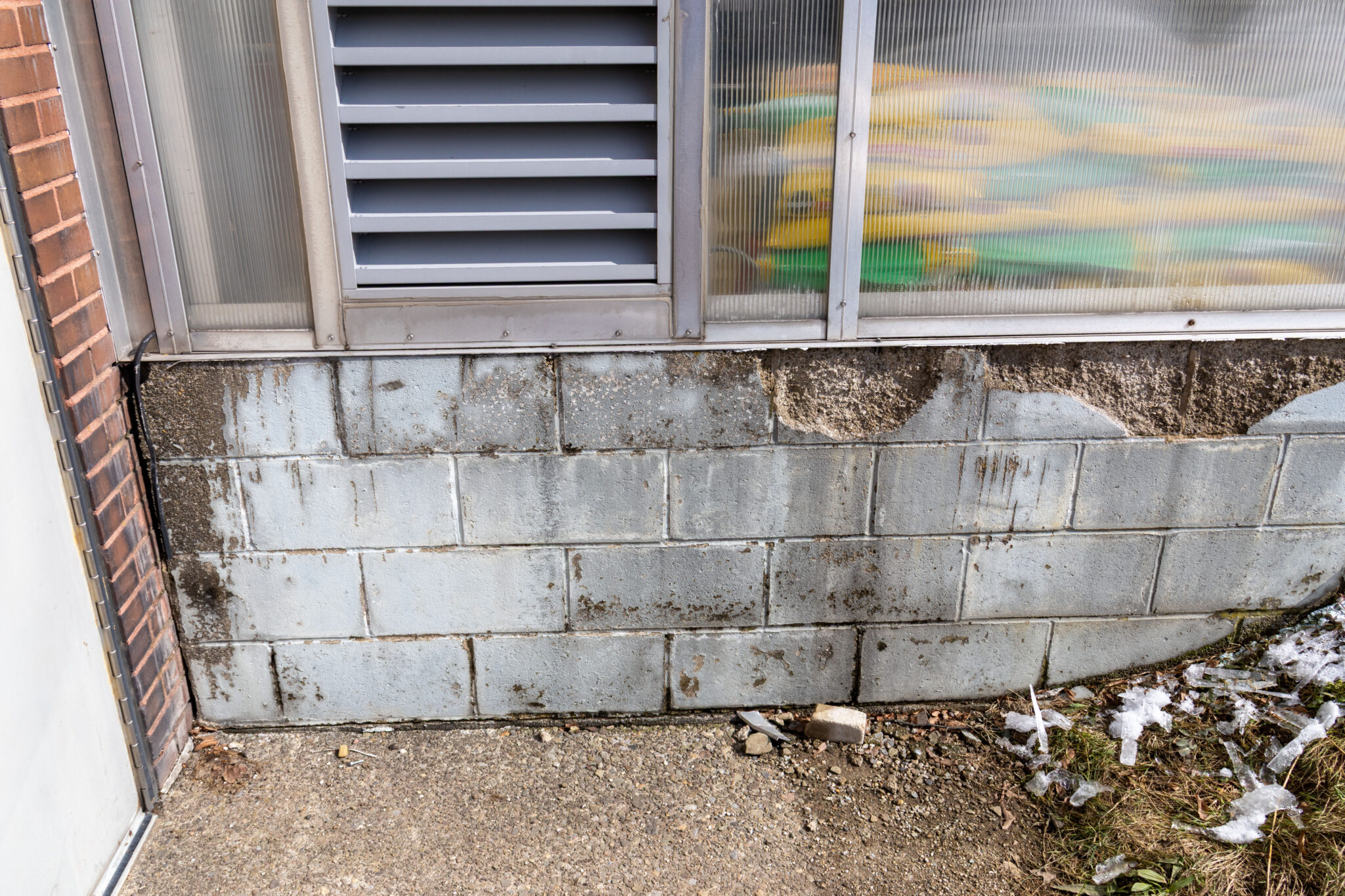

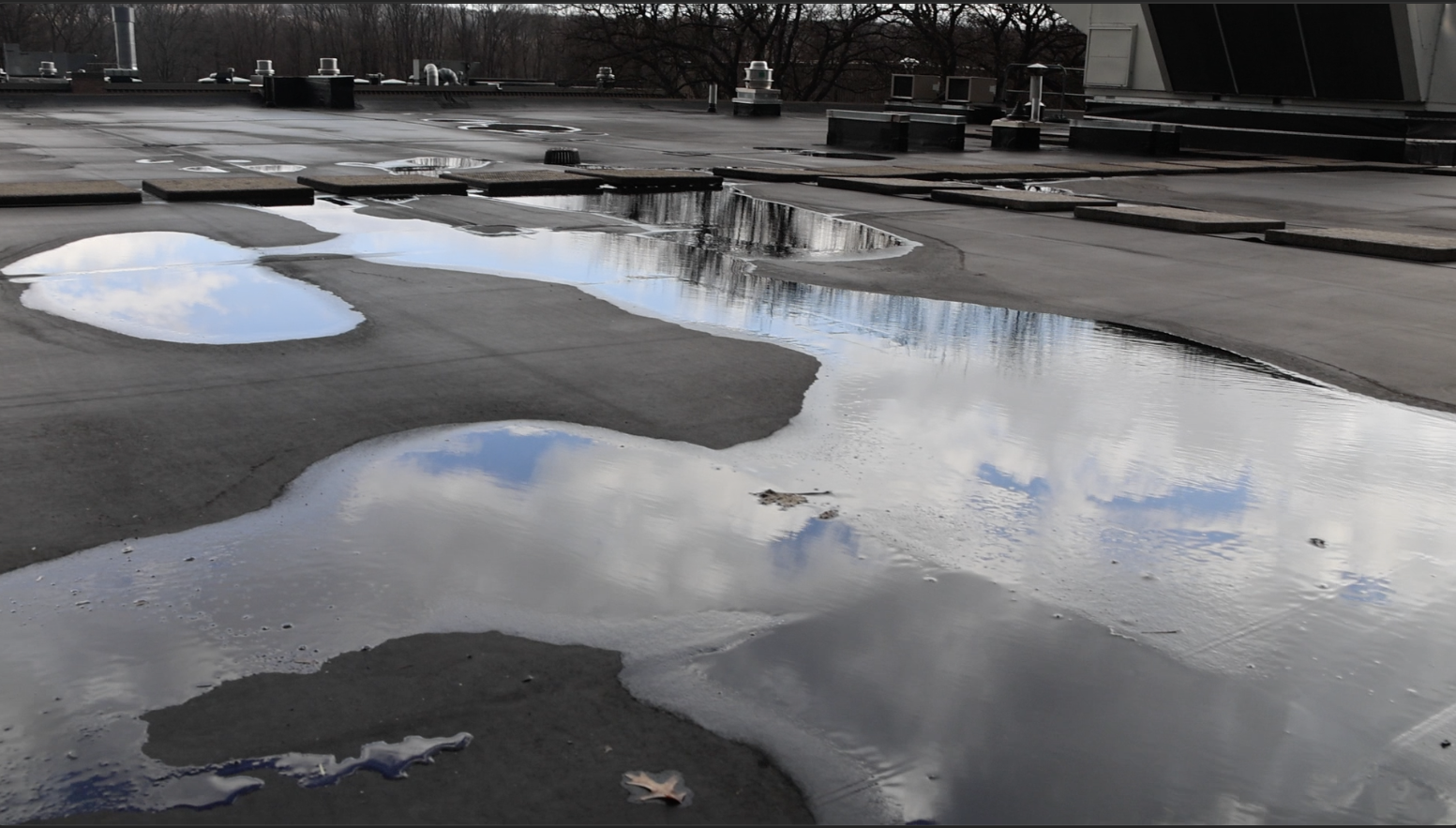

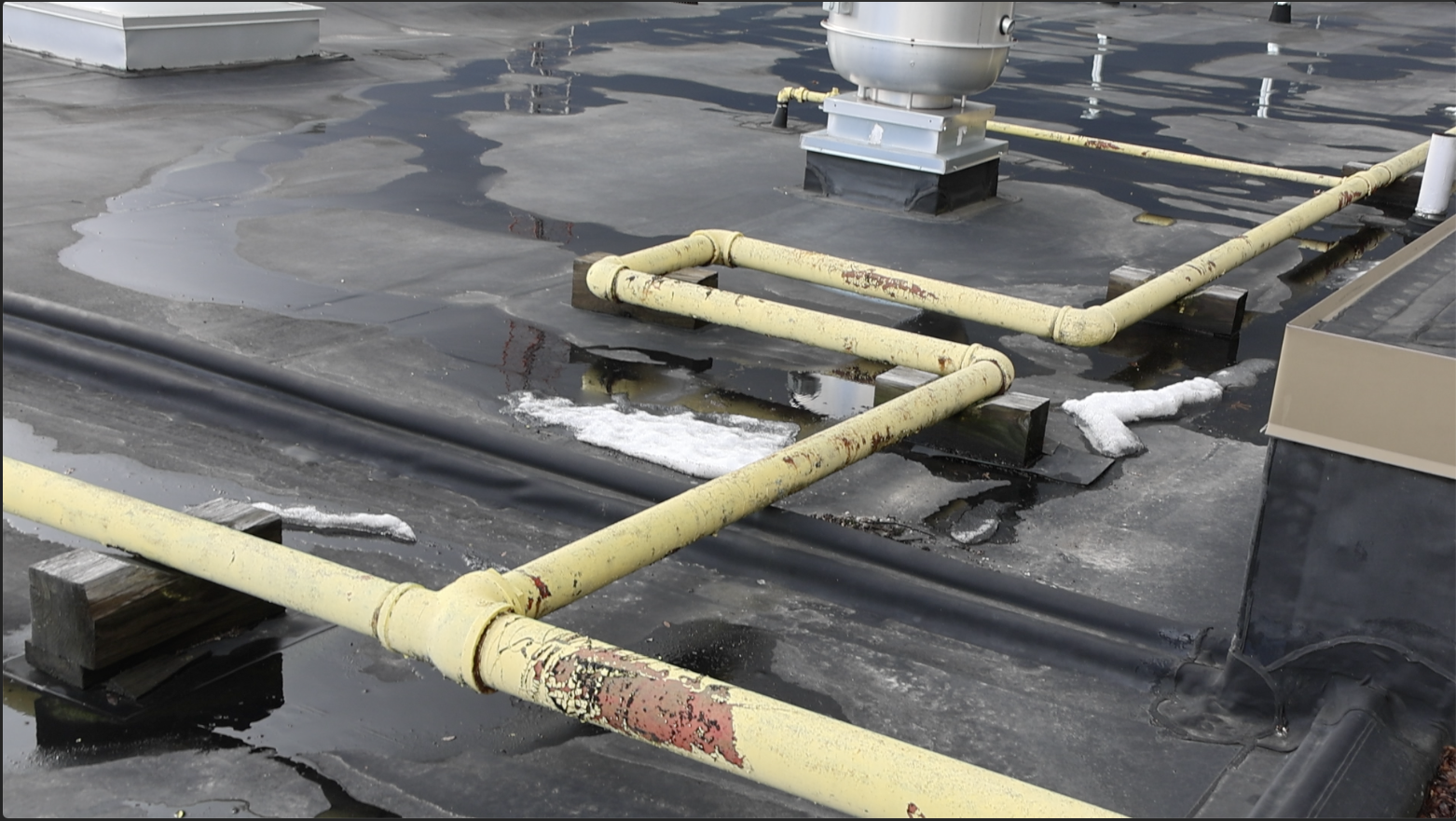

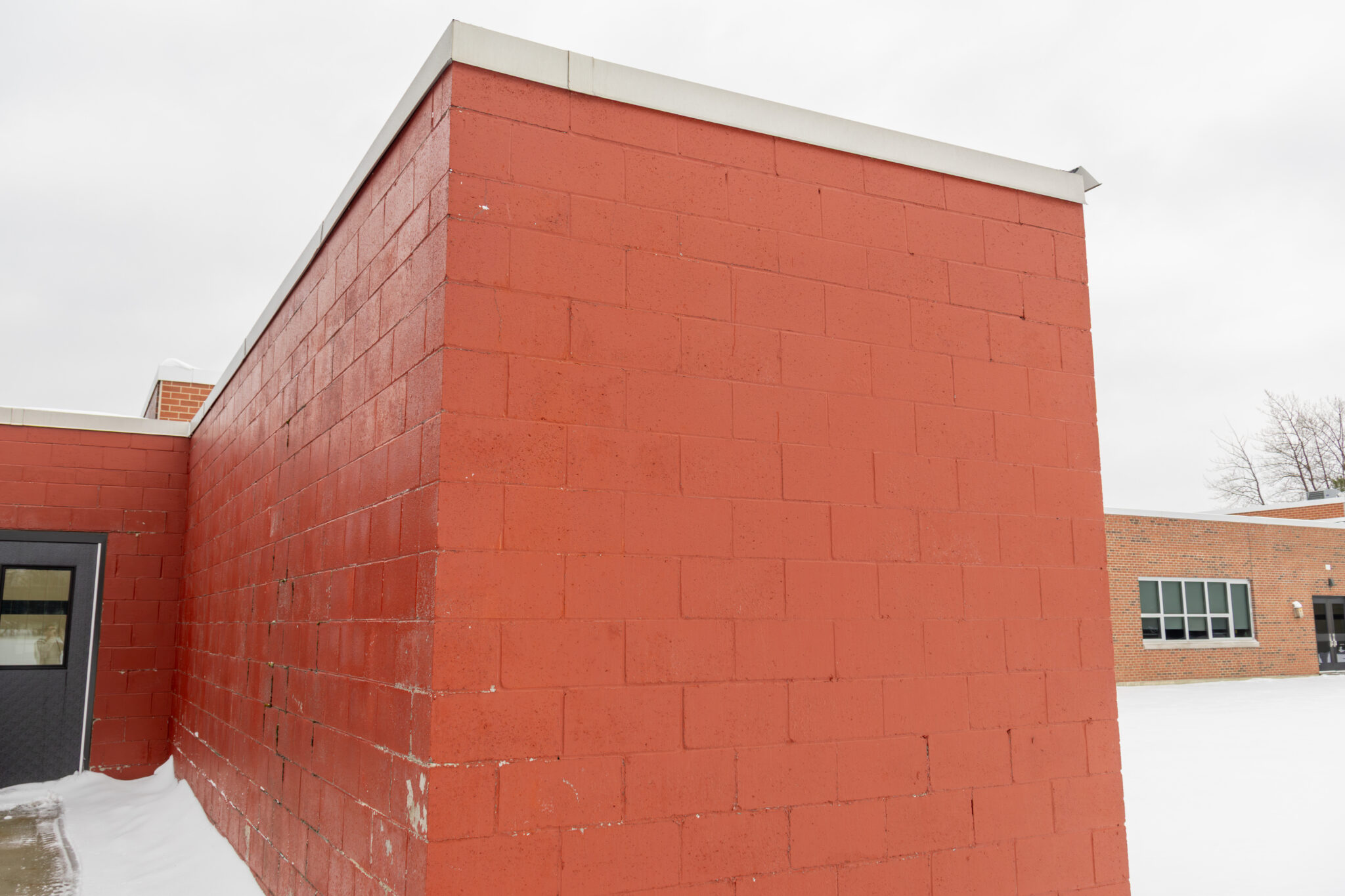

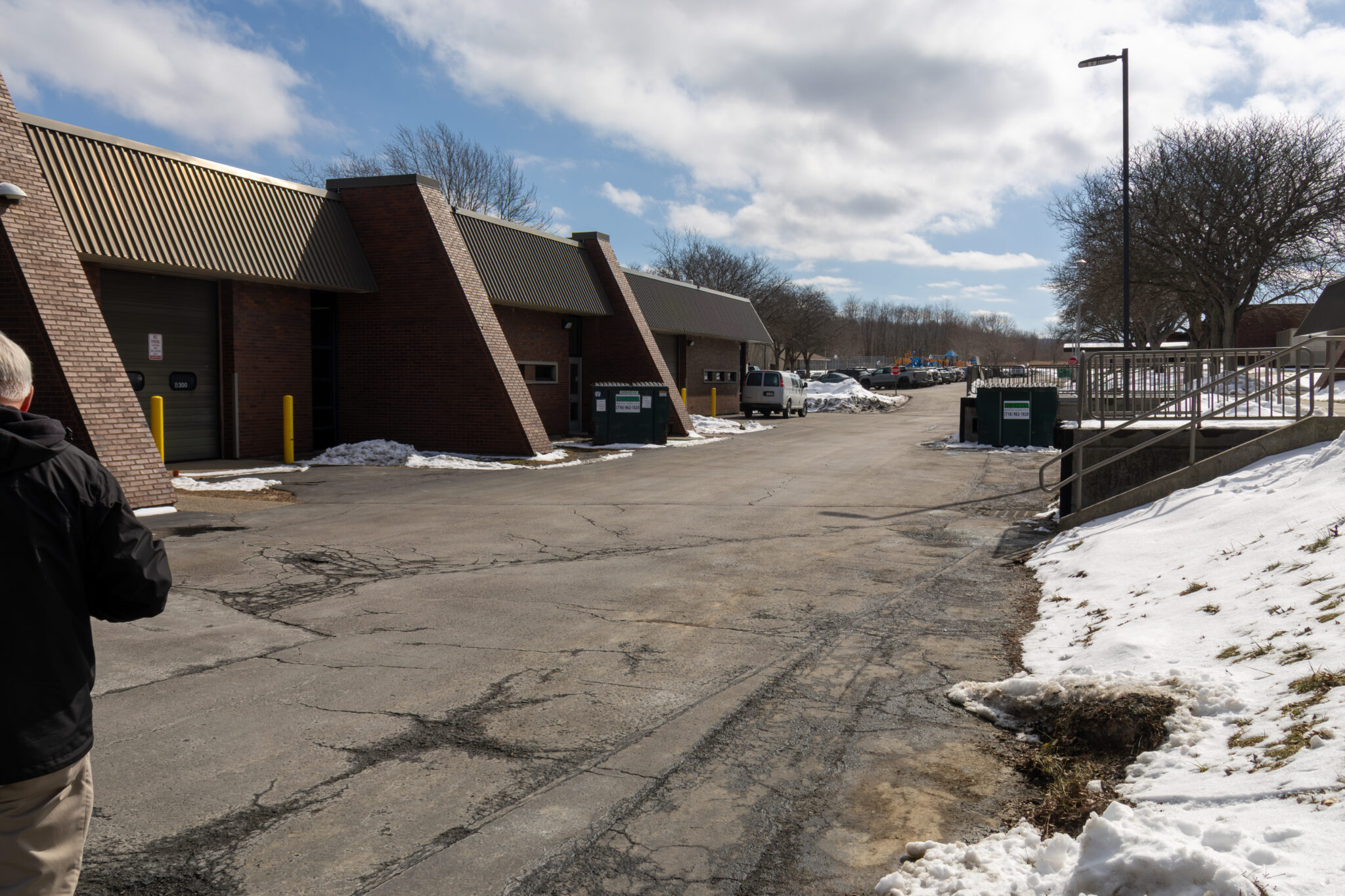

  • LoGuidice Educational Center: Critical building envelope repointing; full resurfacing of the LoGuidice A building roof; replacement of aging mechanical equipment.
Unlike a standard local district referendum, this project utilizes an Inter-Municipal Agreement (IMA). This project relies on the collective, unanimous support of the boards of education from all 27 component districts.
To ensure fiscal efficiency, E2CCB utilized a “Maximum Cost Allowance” (MCA) strategy. Because the $49.5 million scope fits entirely within the MCA for each building, the project is 100% aidable by the New York State Education Department (NYSED). Furthermore, because BOCES facilities aid is received in the same year the payments are made, the net impact on local budgets is significantly reduced and immediate.
Component districts have the flexibility to choose from three strategic pathways to manage their proportional share:
Option 1: Cash Payment
This option represents the lowest total cost to the district by avoiding all interest expenses. Districts utilize available capital reserves to pay their share in scheduled installments. This is the ideal choice for districts seeking the cleanest balance sheet impact and the lowest long-term cost.
Option 2: Five-Year BAN Payoff
Districts may choose short-term borrowing via Bond Anticipatory Notes (BANs). This “bridge” strategy helps manage near-term liquidity and provides budget flexibility while keeping the financing window relatively short, typically matching the project’s construction cycle.
Option 3: Long-Term Financing
This pathway involves bonding the district’s share over a longer term (up to 30 years). While this results in a higher total cost due to interest, it provides the lowest annual payment, which is the most effective strategy for stabilizing annual budgets and managing long-term financial planning.
Capital construction is a multi-year commitment. The timeline for the 2026 project is structured to ensure regulatory compliance and regional accountability from the first governance vote to the final inspection.
The following non-negotiable milestones outline the project trajectory:
  • Governance Window (April 16, 2026 – July 1, 2026): All 27 component district boards must adopt the IMA and associated bond resolutions. Unanimous support is required to move forward.
  • First Payments Due (July 2027): The first of five annual component payments are due to E2CCB.
  • Design & Regulatory Review (2027): Project design finalized and submitted to NYSED for technical review and approval.
  • Construction Phase (2028 – 2032): Staggered physical construction begins across the four campuses following regulatory approval.
  • Project Conclusion (2032): Targeted completion of all site work, infrastructure, and District-Wide IT upgrades.

Frequently Asked Questions

Find answers to common questions about the E2CCB 2026 Capital Improvement Project, including project scope, cost, timeline, state aid, district impact, and next steps. This section is designed to help component districts and community members better understand the need for the project and how it supports safe, reliable learning environments for students.

The distinction lies in the governance and debt-authorization model. Local projects are authorized via public voter referendum. However, because a BOCES cannot carry debt independently, this project relies on an Inter-Municipal Agreement (IMA). The project is authorized through the collective, unanimous resolution of the boards of education from all 27 component districts.

The proposal addresses a critical backlog of deferred maintenance. Our data indicates that only two large-scale capital projects have been executed in the last 20 years. This historical under-investment has resulted in a critical accumulation of infrastructure risks. A comprehensive Building Condition Survey (BCS) — the regulatory driver for this proposal — identified $142 million in total needs across 16 buildings and 4 campuses. Delaying action now increases the risk of system failures that we cannot legally address as “emergencies.”

Costs are distributed via the 2025-26 Resident Weighted Average Daily Attendance (RWADA) methodology. A district’s “Gross Share” is a percentage of the total project cost based on its student population relative to the total BOCES region.

Yes. Because the $49.5M scope fits within the Maximum Cost Allowance (MCA), it is 100% aidable. BOCES facilities aid is received the same year the payment is made.

Districts have three strategic pathways to choose how they’d like to manage this investment:

Option 1: Cash Payment. Direct payment based on the cash flow schedule, which avoids all interest costs.

Option 2: Five-Year BAN Payoff. Short-term borrowing via Bond Anticipatory Notes (BANs) to provide short-term budget flexibility.

Option 3: Long-Term Financing. Long-term debt service intended to spread the cost over several years to manage long-term budget impact.

Local share is determined by the RWADA Aid Ratio.

Gross Share: The total dollar amount assigned to a district.

Local Share: The net cost after the RWADA Aid Ratio is applied.

To authorize the project, local Boards must execute the following checklist:

  • Review and Approval of SEQRA (State Environmental Quality Review Act) documentation.
  • Formal Resolution to Adopt the IMA (Inter-Municipal Agreement) followed by a Bond Resolution.

There is a critical governance window for these approvals. All component Boards of Education must take formal action to adopt the IMA between April 16, 2026, and July 1, 2026.

The $49.5M scope focuses on critical infrastructure:

  • Building Shell ($22M): Includes roof replacements at 12 buildings where systems are currently out-of-warranty and showing clear signs of deterioration.
  • Mechanical & Infrastructure ($12M): Replacement of outdated boilers and HVAC units that have become difficult to service. This includes mandated ventilation upgrades in specific high-use areas.
  • Safety/Site ($6M): Critical restoration of parking lots, pavement, and sidewalks to maintain safe egress and access.
  • Plumbing ($500k): High-priority fixture and supply updates.

Following the IMA adoption in 2026, the project enters the Design and NYSED (New York State Education Department) Review phases throughout 2027. Actual physical construction will begin following these regulatory approvals.

This is a long-term implementation window extending through 2032. Work will be staggered across the four campuses — Hewes, Ormsby, Carrier, and LoGuidice—and will include District Wide IT (DWIT) upgrades.

The prioritization process was highly disciplined, deferring $91 million in identified needs to protect the regional budget:

  • $64M in “SHOULD” Items: This includes $20M for windows, masonry, and foundations; $5.5M for secondary mechanical/plumbing; $3.5M for sidewalks; $6M for lockers/doors/stairs; and $33M for additional program space renovations.
  • $27M in Maintenance Items: Routine electrical, IT, plumbing, and interior items that will be addressed through the annual general fund rather than capital financing.
